On the project properties page when the 'Resource Demand Period' field is set to Weeks, the Calendar dropdown on the resource allocation page will allow the user to view the data in rolled up fiscal month periods.
Resource Allocation page display changes

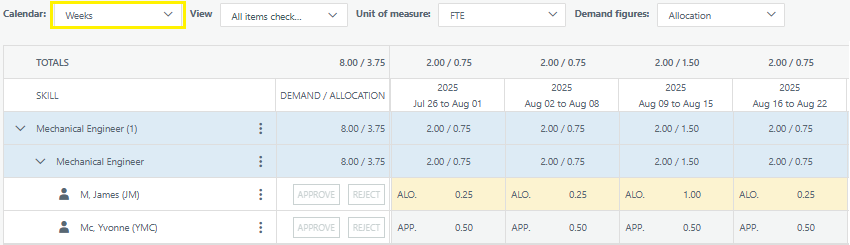

The Calendar dropdown will default to Weeks as this is the working calendar

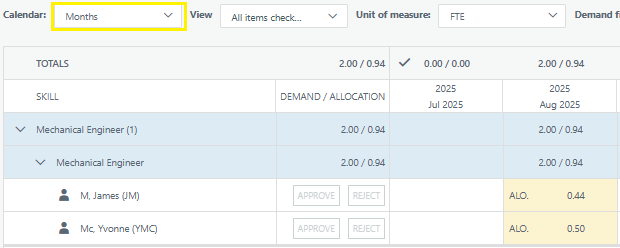

If the user changes Calendar from Weeks to Months the weekly data is rolled up to show by Fiscal month
The roll up work with each of the UOM (FTE, Days and Hours)
The roll ups include skill demand and user assignments
Note: On the project properties page when the 'Resource Demand Period' field is set to Months, the Calendar dropdown on the resource allocation will only display fiscal Months, there is no logic built in to convert from months to weeks
