Admin - Work Breakdown Structure (WBS) Register

Modified on Tue, 6 Oct at 4:39 PM

GovCon: Work Breakdown Structure (WBS) Register

The Work Breakdown Structure (WBS) register is a  standardized register for creating and managing the Work Breakdown Structure, ensuring full traceability across budget, contractual, and organizational dimensions.

 Toggles

Feature Toggle(s)

Permanent Toggle(s)

AlternativeHierarchies
Contract_Management

 ?️ Configuration (Admin)

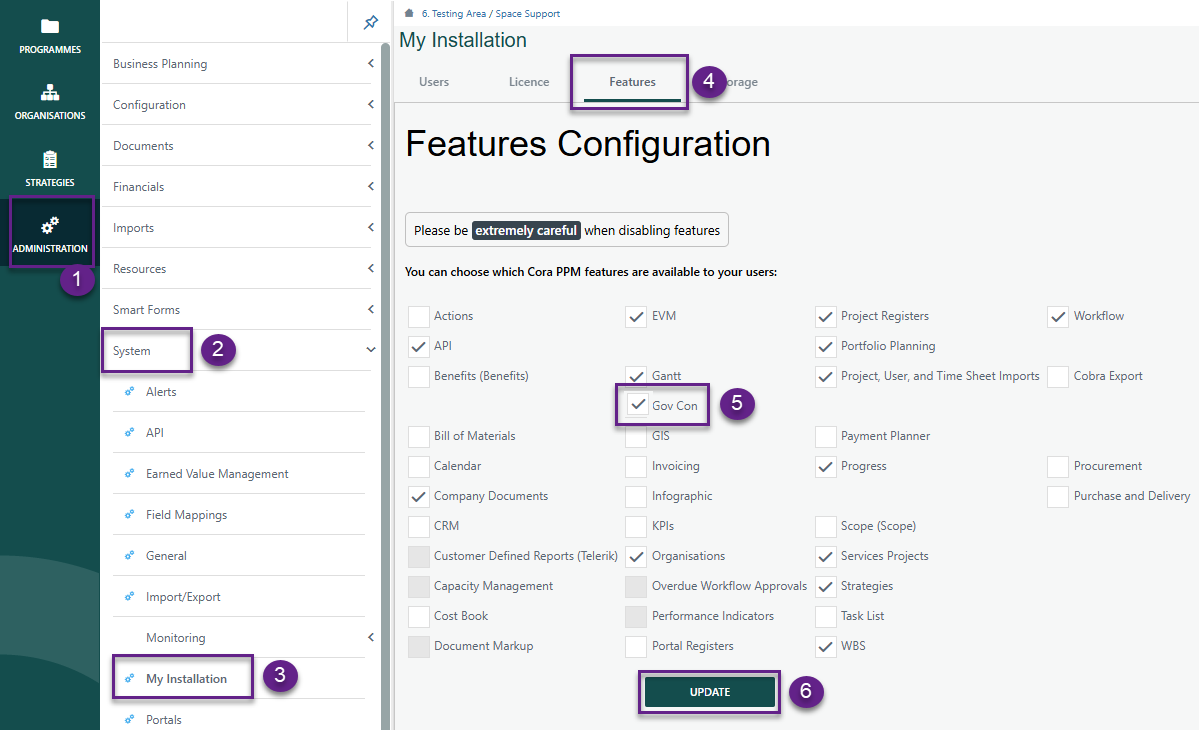

  • Administration > System > My Installation > Features

    • Ensure GovCon is checked and click Update

If not already created, an Element of Cost dropdown is required. To set it up:

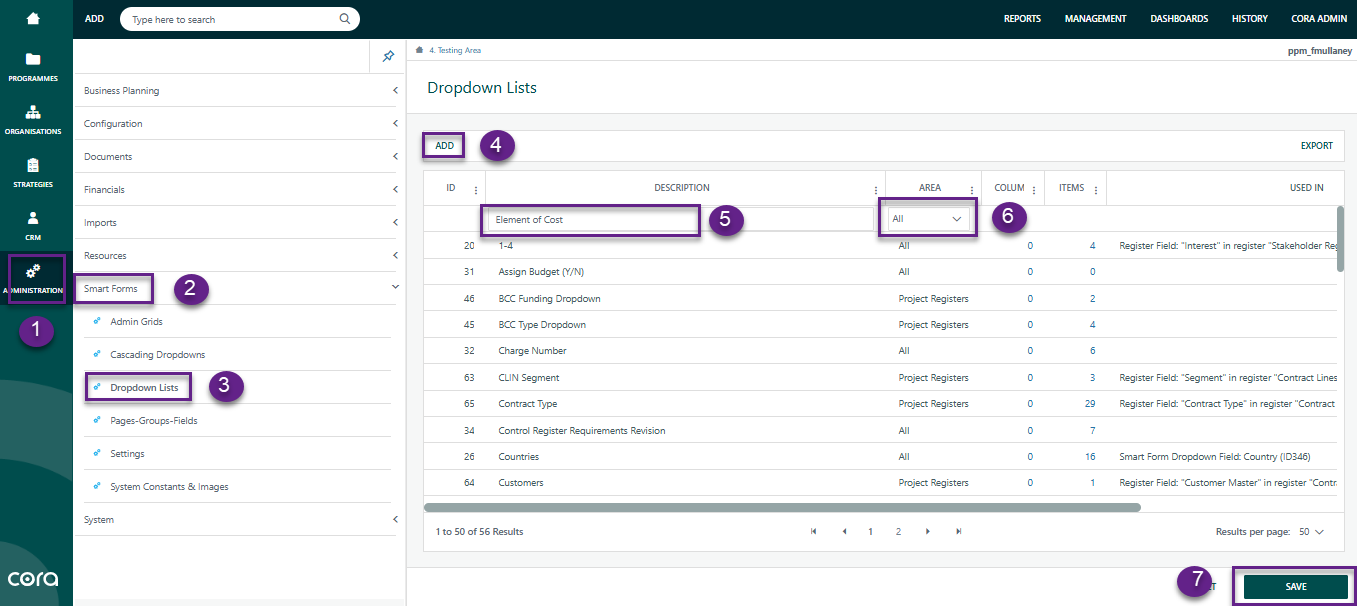

  • Navigate to Administration > Smart Forms > Dropdown List.

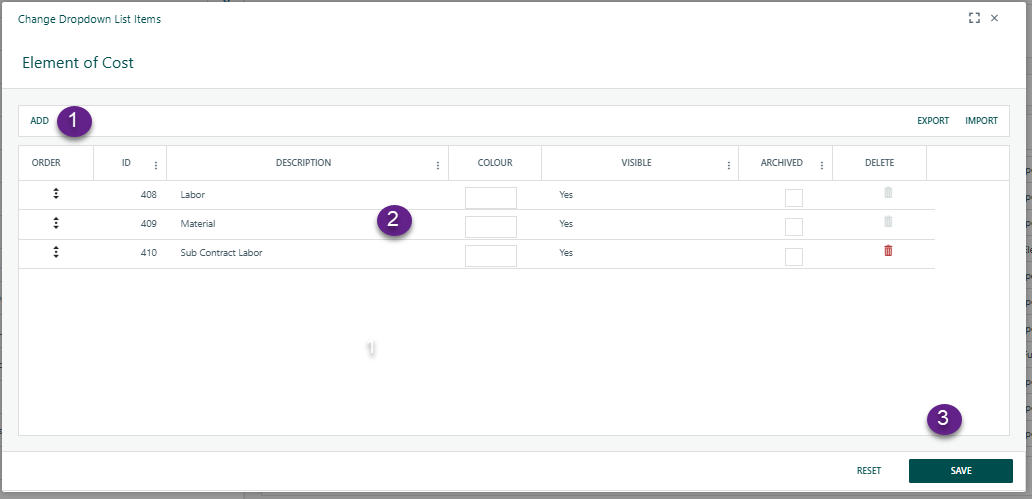

  • Click Add, enter Element of Cost as the name, set Area to All, and click Save.

  • Click the # hyperlink next to the new entry to add your dropdown values.

  • Once finished, click Save.

Setting up Register

  • Navigate to Administration > Configuration > Project Registers.

    • By clicking the GovCon feature under My Installation, the register, its fields, and corresponding dropdown lists are automatically created.
  • Under Fields, both standard and additional WBS system fields will be displayed. The system fields specific to the WBS register are listed below.
  • Suggested Configuration

    • Make CLIN Segment a Register Attribute to support a better User Experience.
    • This UX designed will be enhanced in a future release.

Field Name

Type

Req'd

Source

Group Name

WBS Number

Hierarchy

Y

Hierarchy field type

WBS

WBS Type

Single select custom list

Y

Dropdown List: WBS Type

WBS

WBS Code

Single select custom list

Y

Dropdown List: WBS Code

WBS

Description

Text

Y

existing out of box field
change Display Height: to 1

WBS

CLIN Segment

Single select reference dropdown type

Y

Source: CLIN Register. Register field: Segment

WBS

CLIN Reference Number

Single select reference dropdown type

Y

Source: CLIN Register. Register field: Reference Number

WBS

Assign Actuals (Y/N)

Yes/No

Y

Yes/No

WBS

Assign Budget (Y/N)

Yes/No

Y

Yes/No

WBS

Budget Amount

Numeric

Y

open field

WBS

OBS

Single select reference dropdown type

N

Source: OBS Register. Register field: OBS Code

WBS

Charge Number

Text

N

Display Height: 1

WBS

CAM

Single select user list

N

user dropdown list for now

WBS

EOC

Single select custom list

N

From Account Codes. Droopdown selected in the Element of Cost list: under Admin | Financials | Codes | Account Config tab.

WBS

EVT

Single select custom list

N

Dropdown List: WBS EVT

WBS

Parent ID

Single select register record

N

existing out of box field

WBS

WBS Dictionary

Text

N

Display Height: 2
Maximum Length: defautl 2000 chars

WBS

Task Link

Single select task list

N

list of tasks on the current project

WBS

Raised By

Single select user list

Y

existing out of box field

Details

Raised Date

Date

Y

existing out of box field

Details

Owned By

Single select user list

N

existing out of box field

Details

Target Date

Date

N

existing out of box field

Details

Status

Single select custom list

Y

existing out of box field

Details

Last Date Updated

Date

N

existing out of box field

Details

Order

Numeric

N

existing out of box field

Details

Level

Calculated Field (Integer)

N

existing out of box field

Details

Budget Amount field set Allow Change = No. Budget field is updated based on the Planned Cost field on Gantt to the linked tasks upon 1) approved project baseline and/or 2) applied Baseline Change Control.
Configuration Suggestion: add an Estimated Amount that end user can populate as guidance until PMB is captured.

  • Additional fields can be added per the customers requirements.
  • Once completed, click Save.

Note: The dropdown list for system WBS fields is prepopulated and required. However, Admins can modify existing values or add new ones as needed.

WBS Type

WBS Code

WBS EVT

Summary (SUM)

SUM

XX/YY

Control Account (CA)

CA

0/100

Work Package (WP)

WP

50/50

Planning Package (PP)

PP

Level of Effort

Summary Level Planning Package (SLPP)

SLPP

Apportioned Effort

Incremental Milestone

Percent Complete with QBD

Percentage Complete

Units Complete

Program Evaluation Review Technique (PERT) Cost Formula

No Earned Value

 Reminder: Be sure to add your new register to the project tool bar.

Configuration Suggestion: Enable the ability to “Include in Copy Project” for users to be able to copy this register content from one project to another.

Work Breakdown Structure Register is built on Cora's native Register functionality. See the general Register articles for further capabilities.

? Items to be aware of (Gotchas!)

Item

Admin, End User, or Both

 Earned Value Management - WBS Register is required for EVM.

 Both

WBS Register references the OBS Register & Contract Line Register, therefore both are required and need to be created before the WBS Register.

Both

An APPROVED Project Baseline is required for WBS register as it update the Budget Amount field.

Admin

Was this article helpful?

That’s Great!

Thank you for your feedback

Sorry! We couldn't be helpful

Thank you for your feedback

Let us know how can we improve this article!

Select at least one of the reasons
CAPTCHA verification is required.

Feedback sent

We appreciate your effort and will try to fix the article
